Epoch Clock

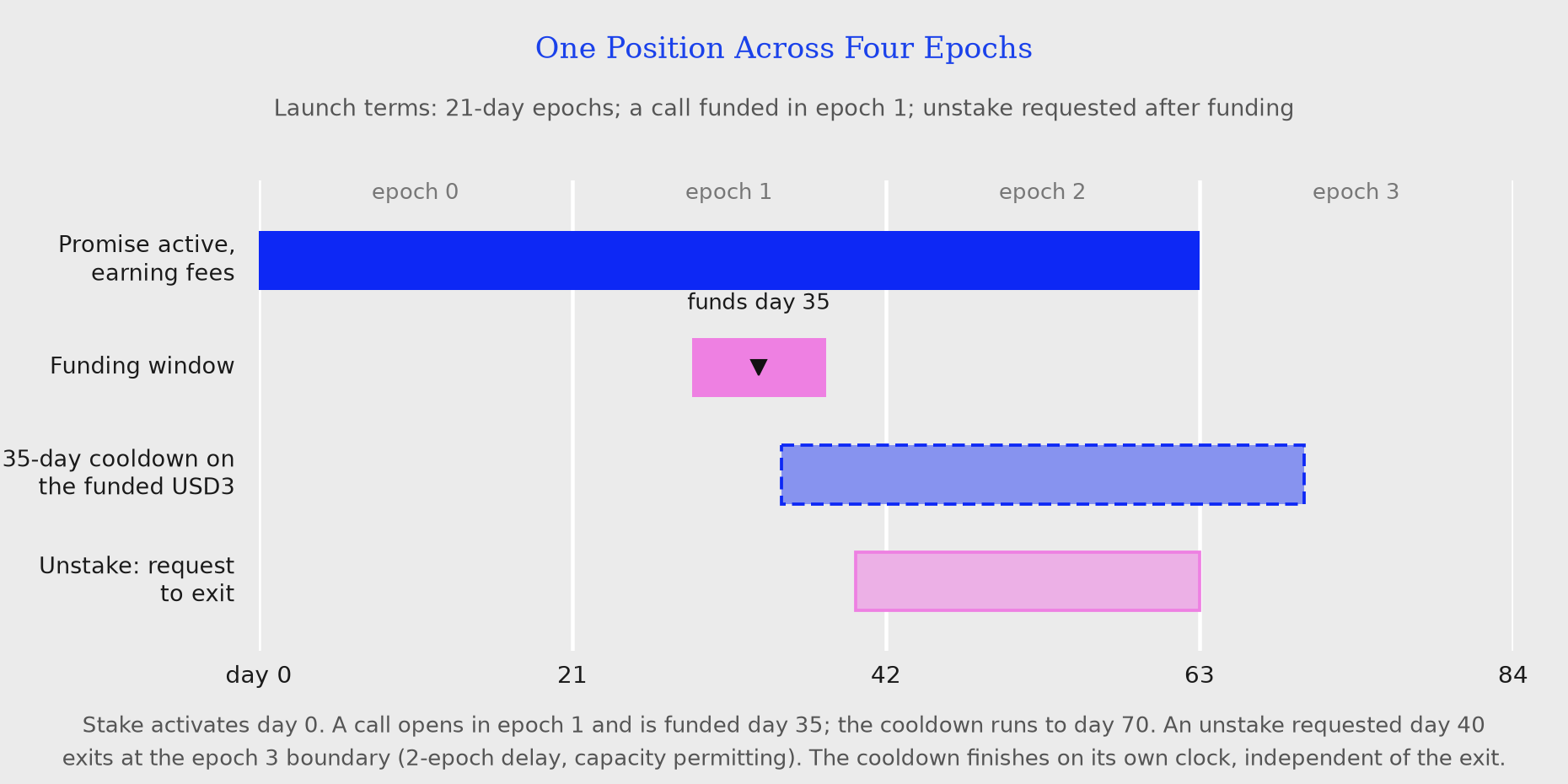

Every LCC facility runs on a fixed-length epoch. Phase boundaries are functions of the timestamp only; no keeper advances state. Day ranges below show the launch schedule of a 21-day epoch.
Normal
New stakes activate; no call can open
PreCall
3Jane may open at most one capital call for the epoch
Funding
Called stakers fund their obligations in USDC
Closed
Slash finalizes; the shortfall auction runs
Phase durations are per-facility terms. At launch: 21-day epochs with a 2-day call decisioning window, a 9-day funding window, and a 4-day auction window. See Facility Parameters.
If no call opens during PreCall, the epoch completes with no obligations.

Facility end states
End of term
The facility's last callable epoch passes
Withdraw-only: no new stakes, calls, or unstake requests; stakers claim remaining margin directly
Shutdown
3Jane shuts the facility down
Same direct claim path. A shutdown before an open call's funding deadline disables slashing for that call
Paused
Circuit breaker, no time bound
All activity freezes; every deadline shifts by the paused duration, so no one is slashed for time elapsed during a pause
